Museum of American Exceptionalism
← Builders

Black Canyon, Nevada–Arizona · 30 September 1935 · Six Companies

The Greatest Dam in the World

In the depths of the Depression, 21,000 Americans pushed a river out of its bed and poured a wall of concrete 726 feet high across it. They finished more than two years early.

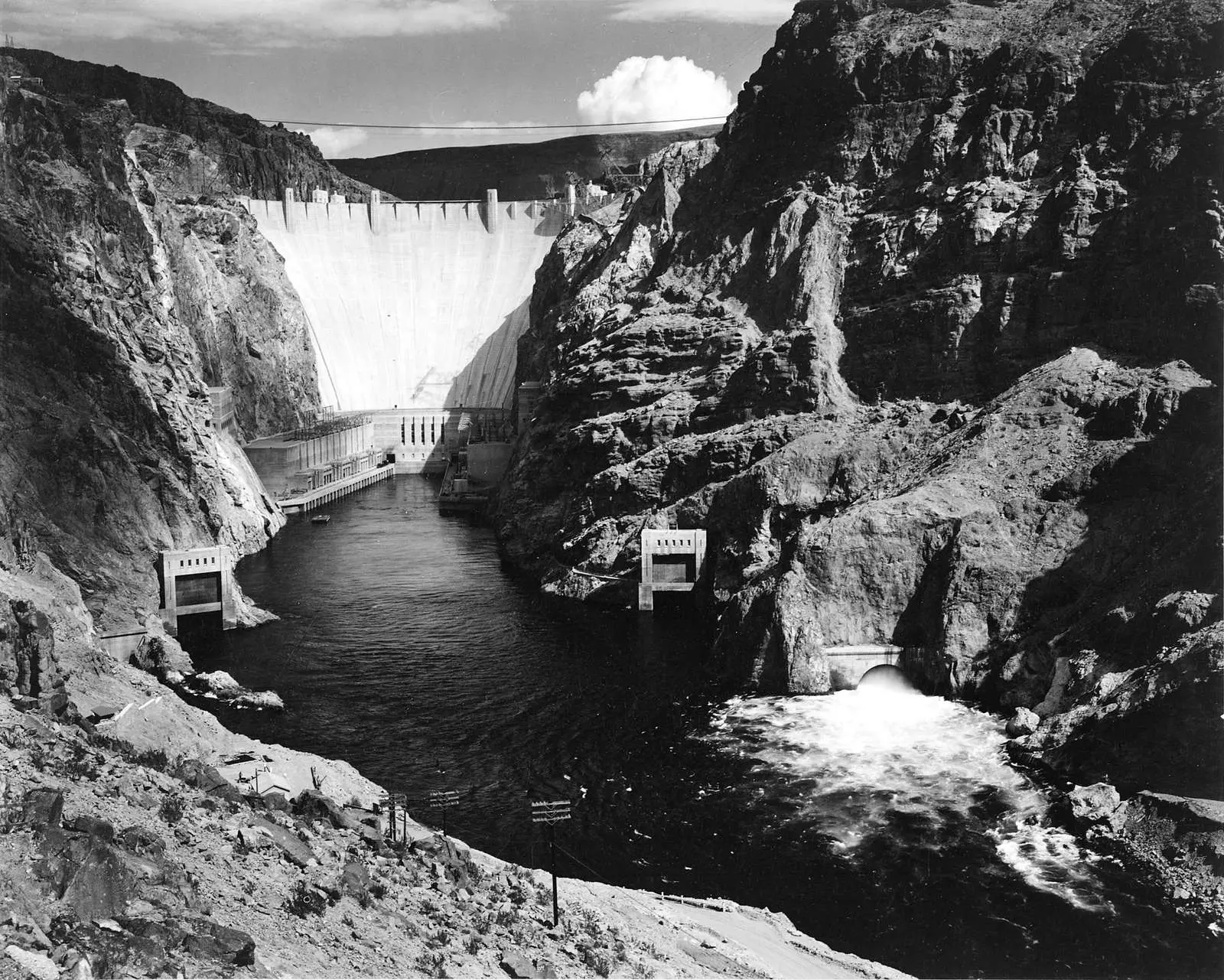

Boulder Dam from downstream, with the canyon-wall outlet works and the Colorado River below, photographed by Ansel Adams, 1941

The moment · June 1935

Every spring the Colorado has drowned the farms of the Southwest. Now 3.25 million cubic yards of ice-cooled, grouted concrete stand 726 feet high across Black Canyon. The spring flood comes roaring down out of the Grand Canyon. It hits the dam. The dam holds.

Boulder Dam from downstream, with the canyon-wall outlet works and the Colorado River below, photographed by Ansel Adams, 1941. Ansel Adams / National Archives (79-AAB-01).
726 ftfrom bedrock to crest
21,000men built it
3.25Mcubic yards of concrete
2 yearsahead of schedule

The Colorado River flooded the farms of the Southwest every spring and ran dry every fall. In 1928 Congress voted to plug it with the biggest dam ever attempted, in a canyon with no road, no rail line and no shade. The country slid into the Depression. Six Western builders took the job anyway. They had seven years. They needed five.

0 200 400 600 726 FT WASHINGTON MONUMENT 555 FT LAKE MEAD HOOVER DAM · 726 FT 660 FT THICK AT THE BASE
Hoover Dam in cross-section beside the Washington Monument, drawn to scale.
  1. Six Companies

    No single builder is big enough for this job, so six Western firms pool their money into one: Utah Construction, Kaiser and Bechtel, McDonald and Kahn, Morrison-Knudsen, J.F. Shea and Pacific Bridge. Their bid of $48,890,995 is the lowest, and the government awards them the contract. They get seven years. To run the job they pick Frank Crowe, who has spent twenty years building dams for the Reclamation Service.

  2. Through the canyon walls

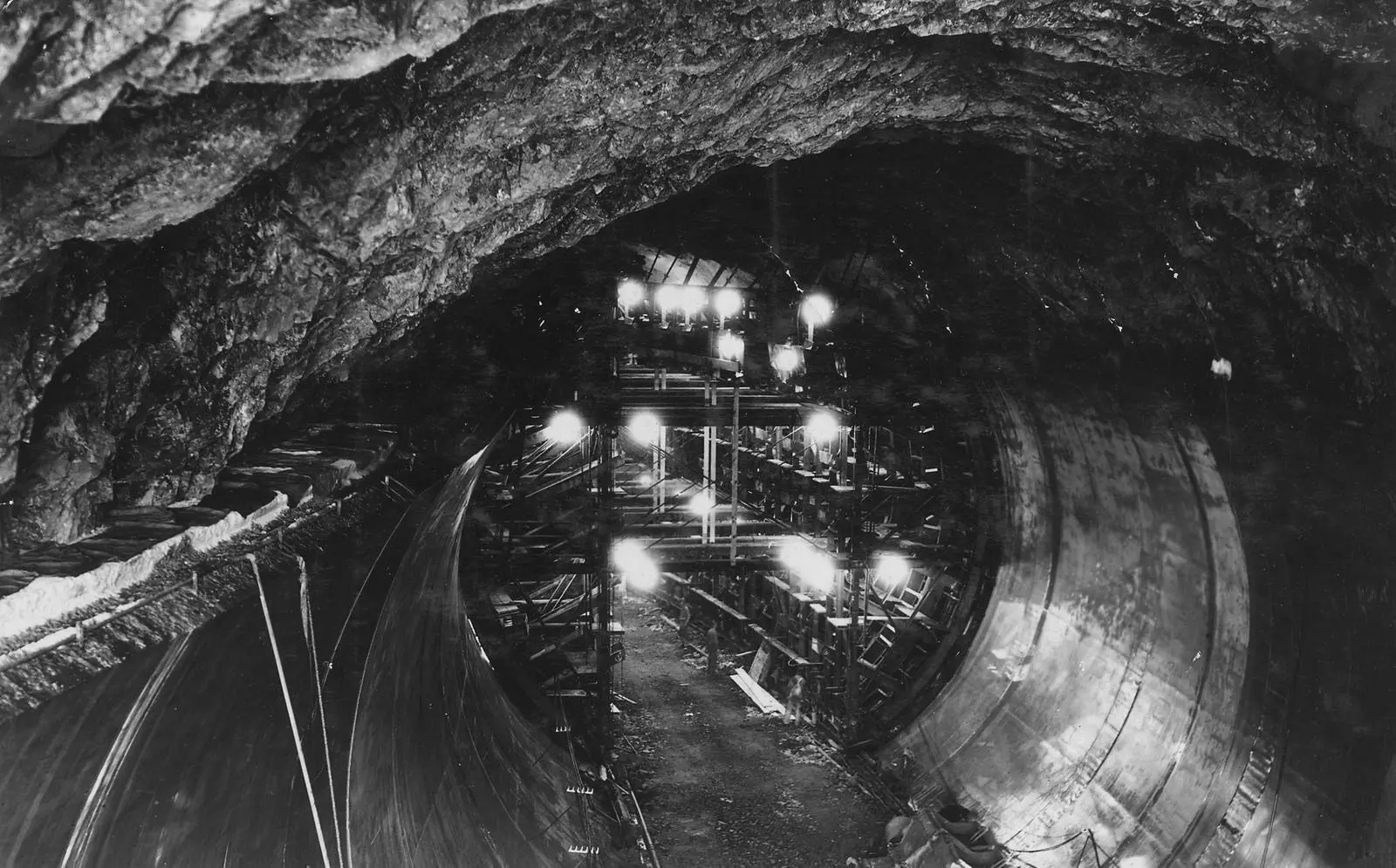

    Before anything can be built, the river has to move. Crews start four tunnels, each 56 feet across, two through the Nevada wall and two through Arizona, more than three miles in all. Crowe mounts 30 drills on the back of a truck so a whole tunnel face is drilled at once. It takes a ton of dynamite for every 14 feet. They haul out 1.5 million cubic yards of rock.

  3. A town from nothing

    The first workers and their families camp by the river in tents and shacks they call Ragtown, with no fresh water and little shade. On the desert above the canyon, the government lays out a new town with streets, a park, dormitories for single men and cottages for families. There are no saloons and no casinos. By early 1932 the families are moving in. Boulder City will house about 5,000 workers.

  4. The high scalers

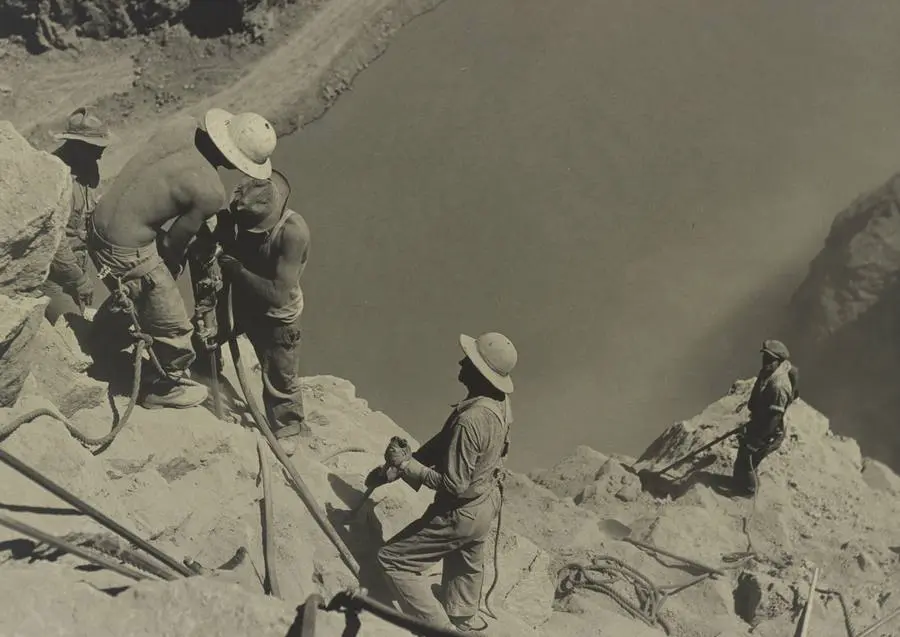

    Every loose rock on the canyon walls has to come off before concrete can touch them. High scalers do it. They swing out over the river on ropes with 44-pound jackhammers and dynamite. They coat cloth hats in tar until they set hard. When engineer Burl Rutledge falls from the rim, high scaler Oliver Cowan swings out and grabs his leg, and Arnold Parks pins him to the wall. Rutledge lives.

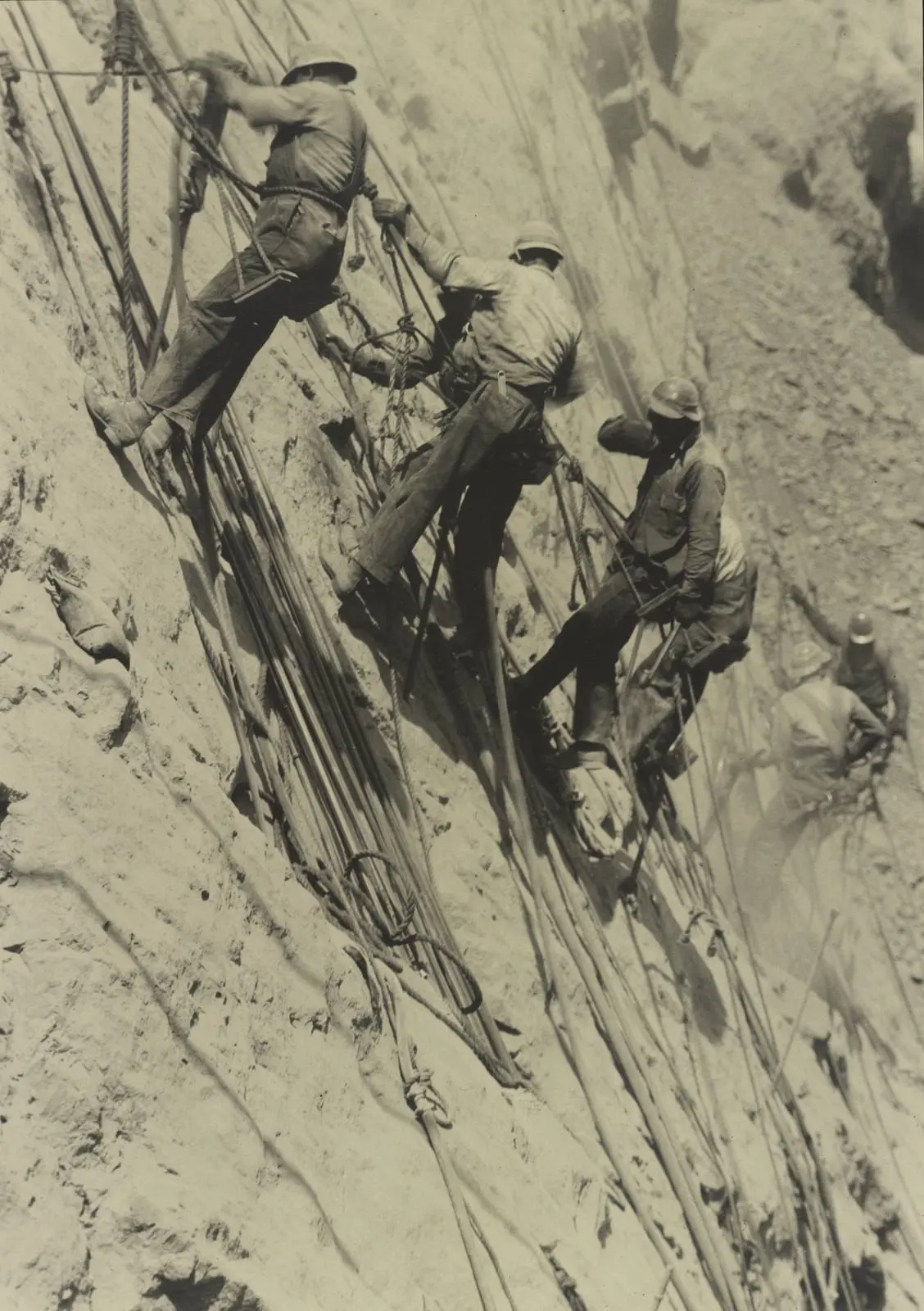

    High scalers on ropes and bosun's chairs work the wall of Black Canyon, photographed by Ben Glaha, c. 1934
    High scalers on ropes and bosun's chairs work the wall of Black Canyon, photographed by Ben Glaha, c. 1934. Ben D. Glaha / U.S. Bureau of Reclamation; Library of Congress.
  5. The river turns

    Trucks dump rock into the channel until the Colorado gives up its bed and pours into the two Arizona tunnels. The contract allowed until 1 October 1933, with a $3,000 fine for every day late. Crowe beats the deadline by more than ten months. Cofferdams go up above and below the site, the riverbed is pumped dry, and the crews dig down to solid rock.

  6. The first bucket

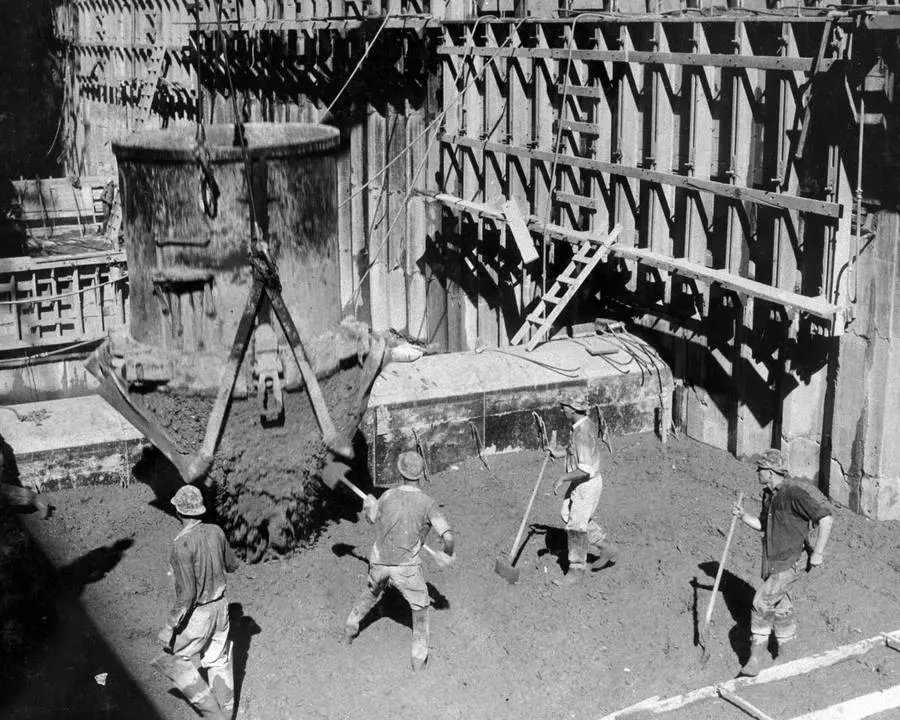

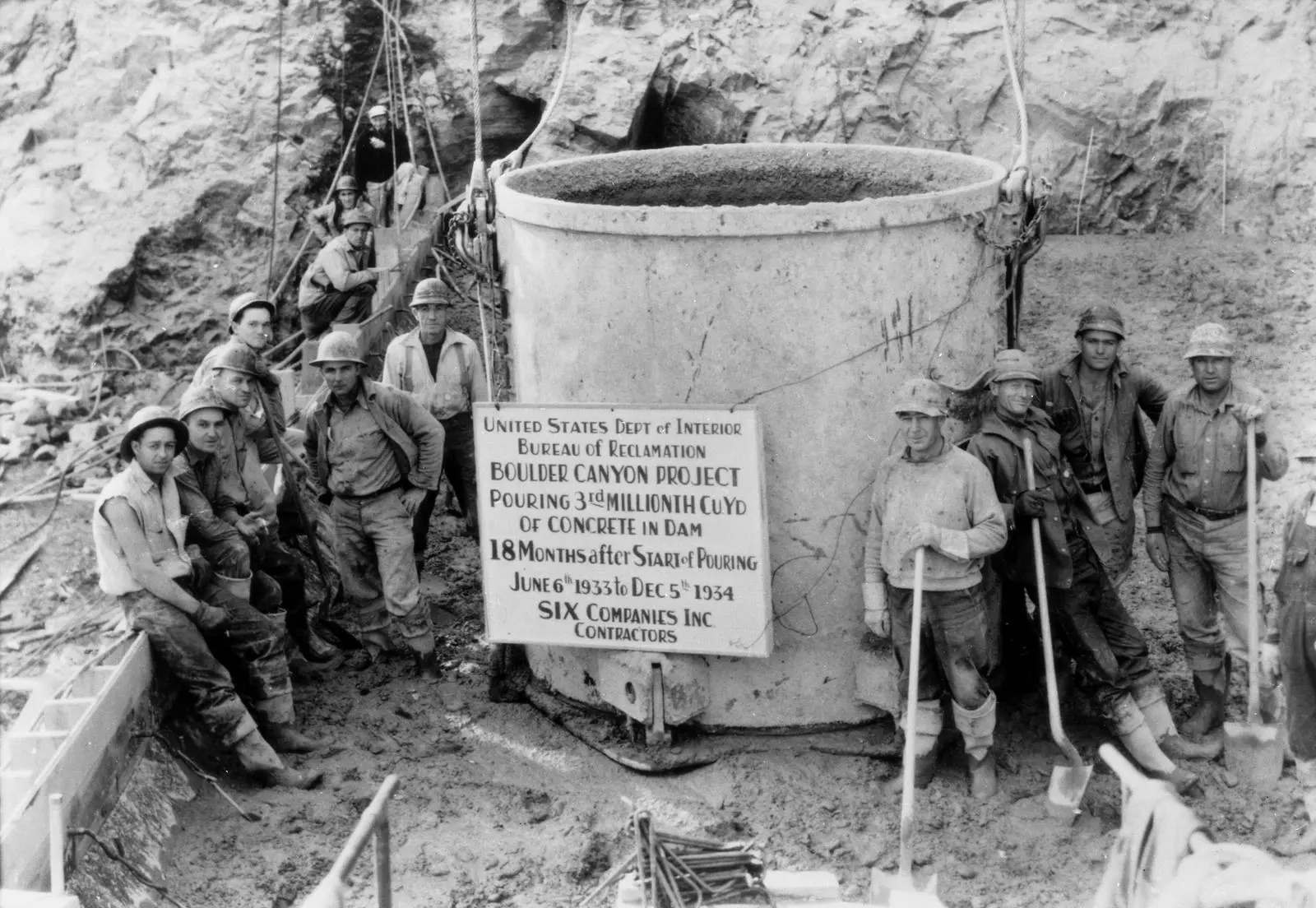

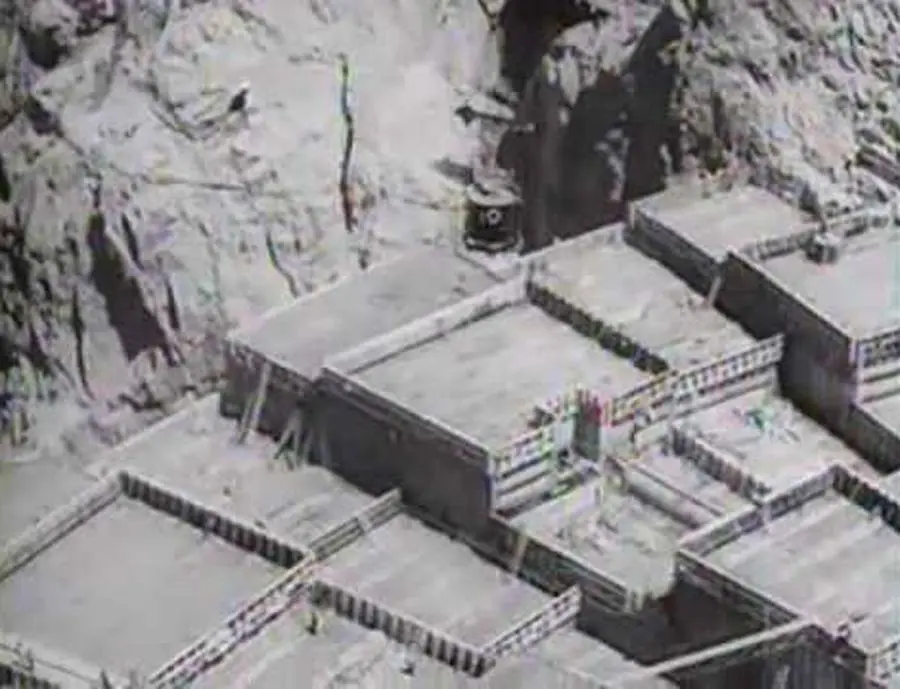

    The first bucket of concrete goes into block J-3, nearly 18 months ahead of schedule. The dam rises as about 215 separate interlocking blocks, from 60 feet square at the upstream face to 25 feet square downstream, poured five feet at a time. Nine cableways strung across the canyon swing buckets of eight cubic yards to any block. The pour runs around the clock.

  7. Ice water in the concrete

    Concrete heats as it sets. Left alone, a mass this size would take 125 years to cool, and it would crack as it shrank. So the builders run 582 miles of one-inch steel pipe through the blocks and pump ice water through it. A plant on site can make 1,000 tons of ice a day. Once a block is cold, the pipes and the joints are pressure-filled with grout, and the blocks become one dam.

  8. Lake Mead begins

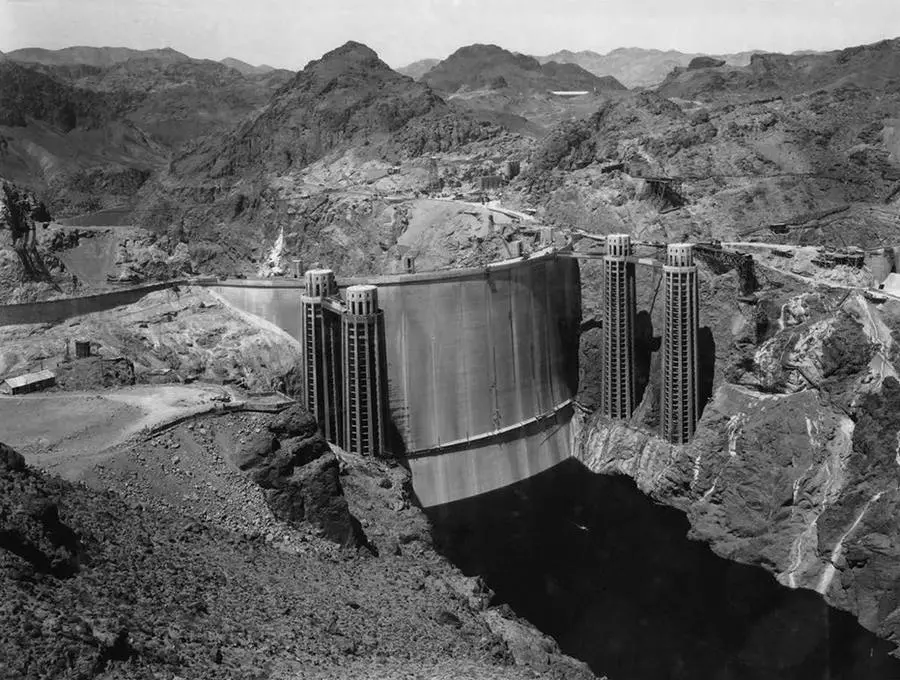

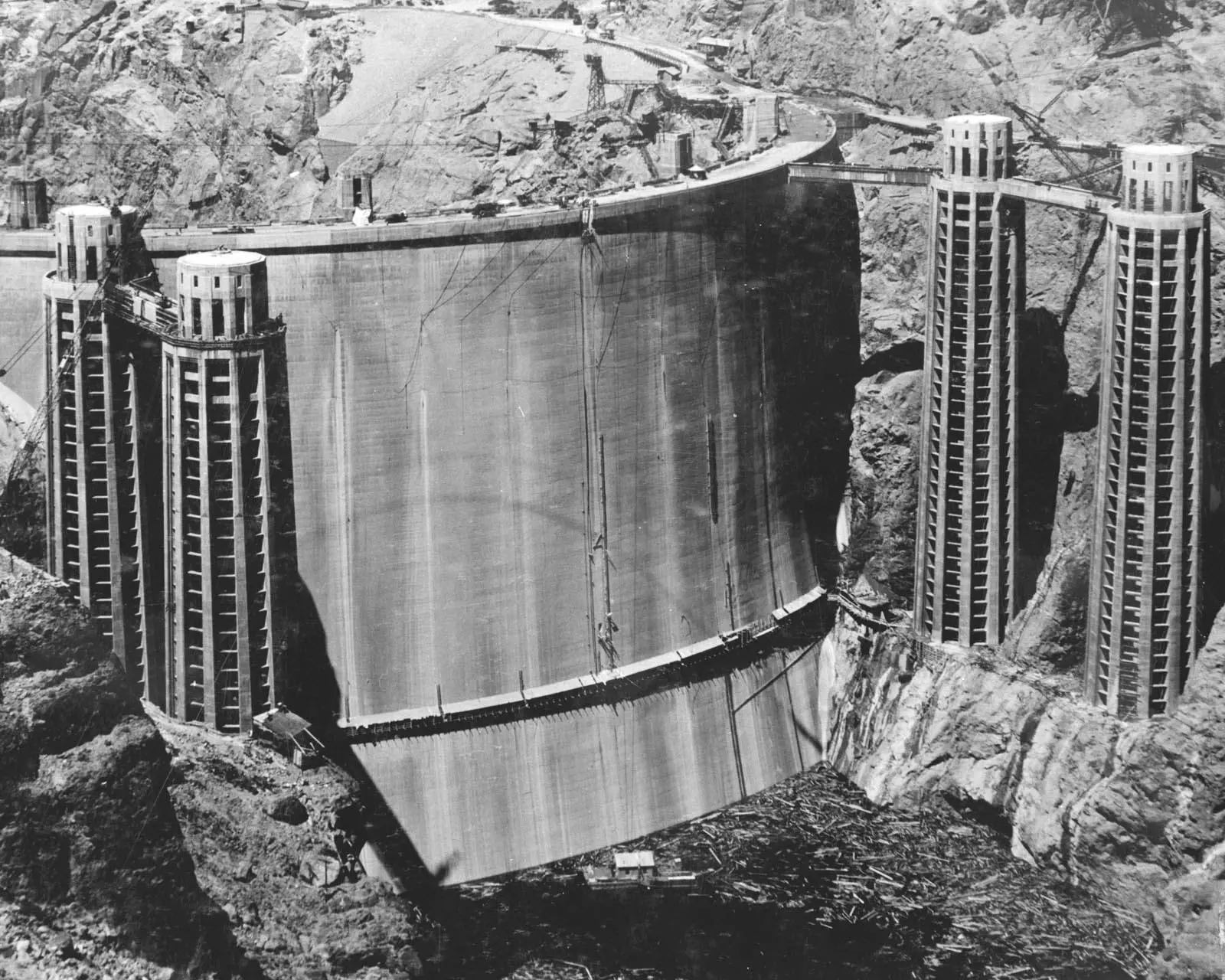

    The gates come down on the diversion tunnels and the Colorado begins to back up behind the dam. On 29 May the last concrete goes in: 3.25 million cubic yards, enough to pave a highway from San Francisco to New York. In June the spring flood comes roaring down through the Grand Canyon. The dam catches it and holds it.

  9. Well done

    President Roosevelt dedicates the dam before about 10,000 people standing in 102-degree heat, with millions more listening on the radio. He calls it the greatest dam in the world and thanks the thousands of workers who gave brain and brawn to it. He closes by speaking for the whole country to the men who built it: “Well done.”

    President Roosevelt, at the damThis morning I came, I saw and I was conquered, as everyone would be who sees for the first time this great feat of mankind.

The builders

Frank T. Crowe, general superintendent for Six Companies Inc., at the dam site, 1935Age 52
General Superintendent, Six CompaniesFrank Crowe

Born in Quebec in 1882 and trained at the University of Maine, he built dams for the Reclamation Service for twenty years. He strung the cableways, ran the job around the clock and finished two years early. “I was wild to build this dam.”

Elwood Mead, Commissioner of Reclamation 1924-1936, July 24, 1928Age 77
Commissioner of ReclamationElwood Mead

Purdue-trained engineer who wrote Wyoming’s water law and ran the irrigation works of Victoria, Australia. As Commissioner from 1924, he carried the dam from bid to dedication. He died in office in January 1936, and the lake behind it bears his name.

High scalers on ropes at the Arizona intake tower site, some 550 feet above the Colorado River, 28 July 1932: the job Joe Kine did at the dam.Age 28
High scalerJoe Kine

He rode a bosun’s chair down the walls of Black Canyon, setting charges and prying loose rock high above the river. The bronze high scaler that stands at the dam, unveiled for its 60th anniversary in 1995, is modeled on him.

Sculptor Oskar J.W. Hansen in his studio beside a winged figure for Minneapolis's Rand Tower, 1929Age 43
SculptorOskar J.W. Hansen

Norwegian-born sailor turned American sculptor. He made the dam’s art: the two 30-foot bronze Winged Figures of the Republic, a star chart in the terrazzo that fixes the date of the dedication, and the memorial to the men who died building it.

By the numbers

660 ftthick at the base, as wide as two football fields end to end
6.6M tonsthe weight of the dam, holding back the Colorado River
582 milesof one-inch pipe that carried ice water through the concrete
125 yearsthe concrete would have taken to cool on its own
1,000 tonsof ice the refrigeration plant could make in a day
3 milesof diversion tunnel, 56 feet across, blasted through solid rock
5,218men on the job on the busiest day
$48.9MSix Companies’ winning bid, opened in Denver on 4 March 1931

Watch, listen, see

Films, photographs and first-hand accounts from across the web. Each opens in a new tab.

“This is an engineering victory of the first order—another great achievement of American resourcefulness, American skill and determination.”

President Franklin D. Roosevelt, dedication of Boulder Dam, 30 September 1935

After

On 1 March 1936, Secretary of the Interior Harold Ickes formally accepted the finished dam from Six Companies, more than two years ahead of the contract deadline. That fall the first generators came on line. By 1939 Hoover was the largest hydroelectric plant in the world.

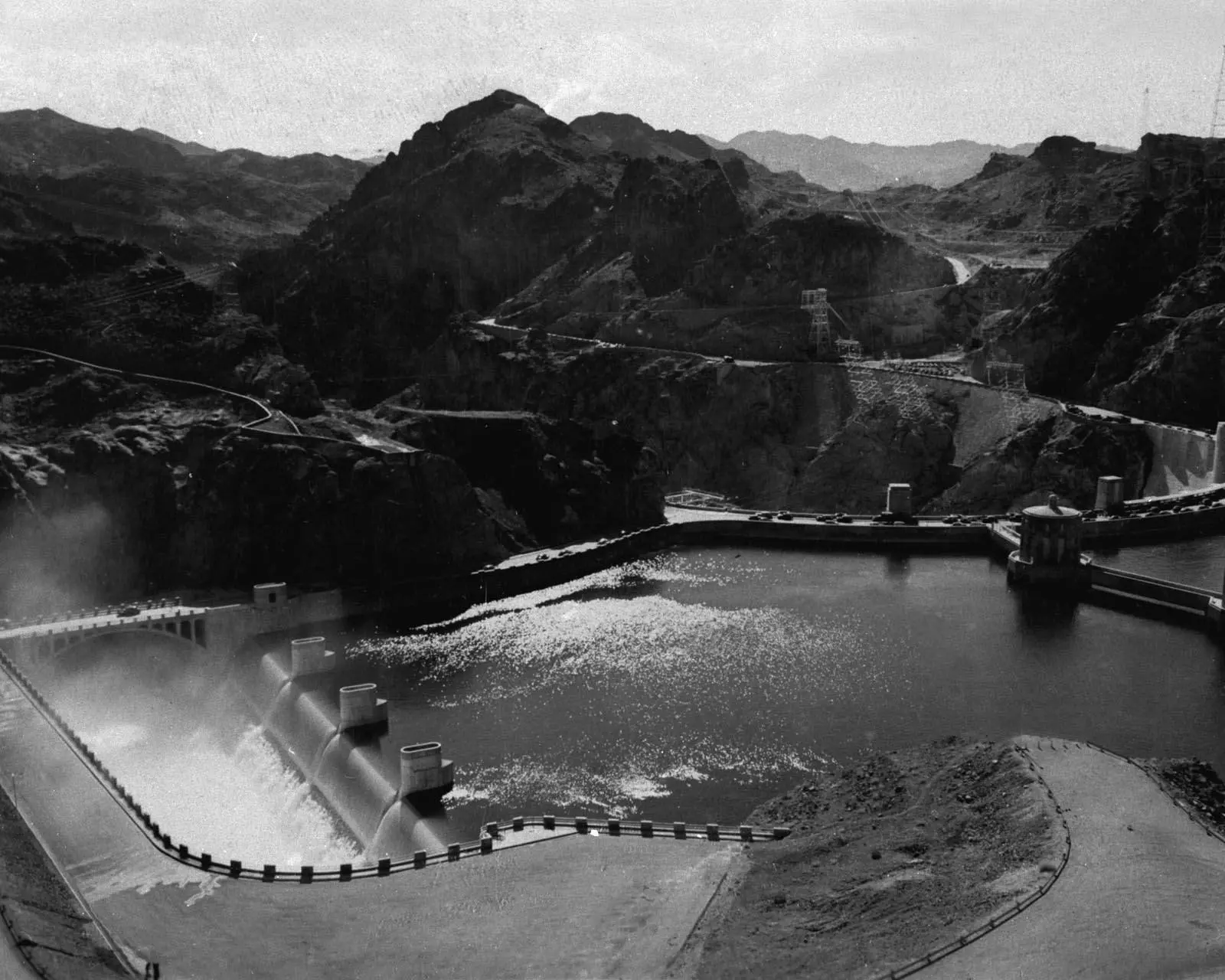

In February 1936, days after Elwood Mead died, the reservoir was named Lake Mead in his honor. It rose to the spillways for the first time in August 1941, a lake more than 110 miles long. A memorial at the dam honors the 96 men who died on the job.

Congress restored the name Hoover Dam in 1947, and the dam became a National Historic Landmark in 1985. Nine decades on, it still stores the Colorado and sends power and water to Nevada, Arizona and California.
